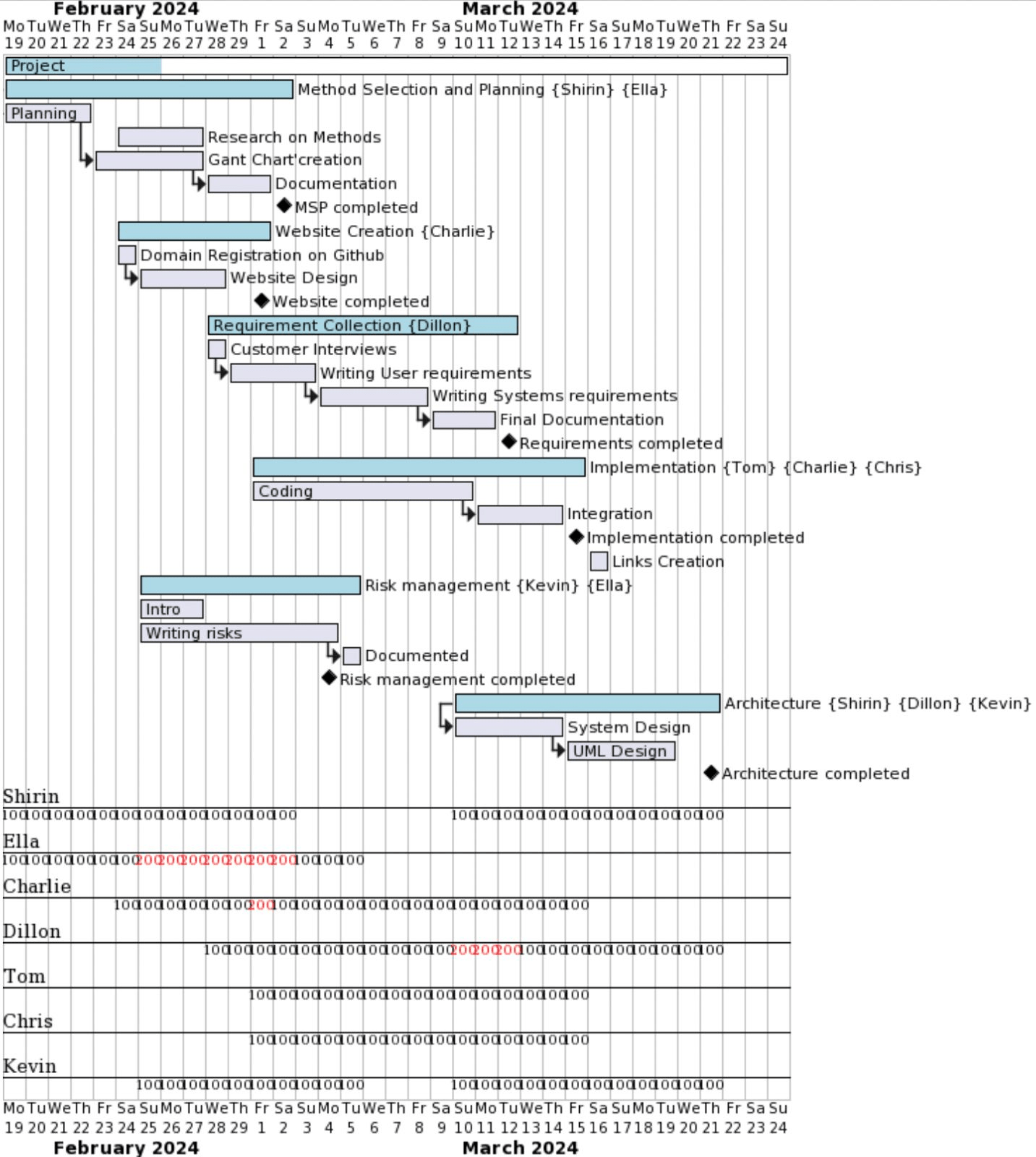

Figure 1 (Week 1)

Gannt Chart 1

Key tasks:

Method Selection and Planning (High Priority)

Start: 2024-02-19, End: 2024-03-15

Includes Research, Planning, Gantt Chart Creation, Documentation

Dependencies: None

Website Creation (Medium Priority)

Start: 2024-02-24, End: 2024-03-01

Includes Domain creation on Github, Website Design

Dependencies: None

Risk Management (Medium Priority)

Start: 2024-02-25, End: 2024-03-15

Includes Introduction, Writing Risks, Documentation

Dependencies: None

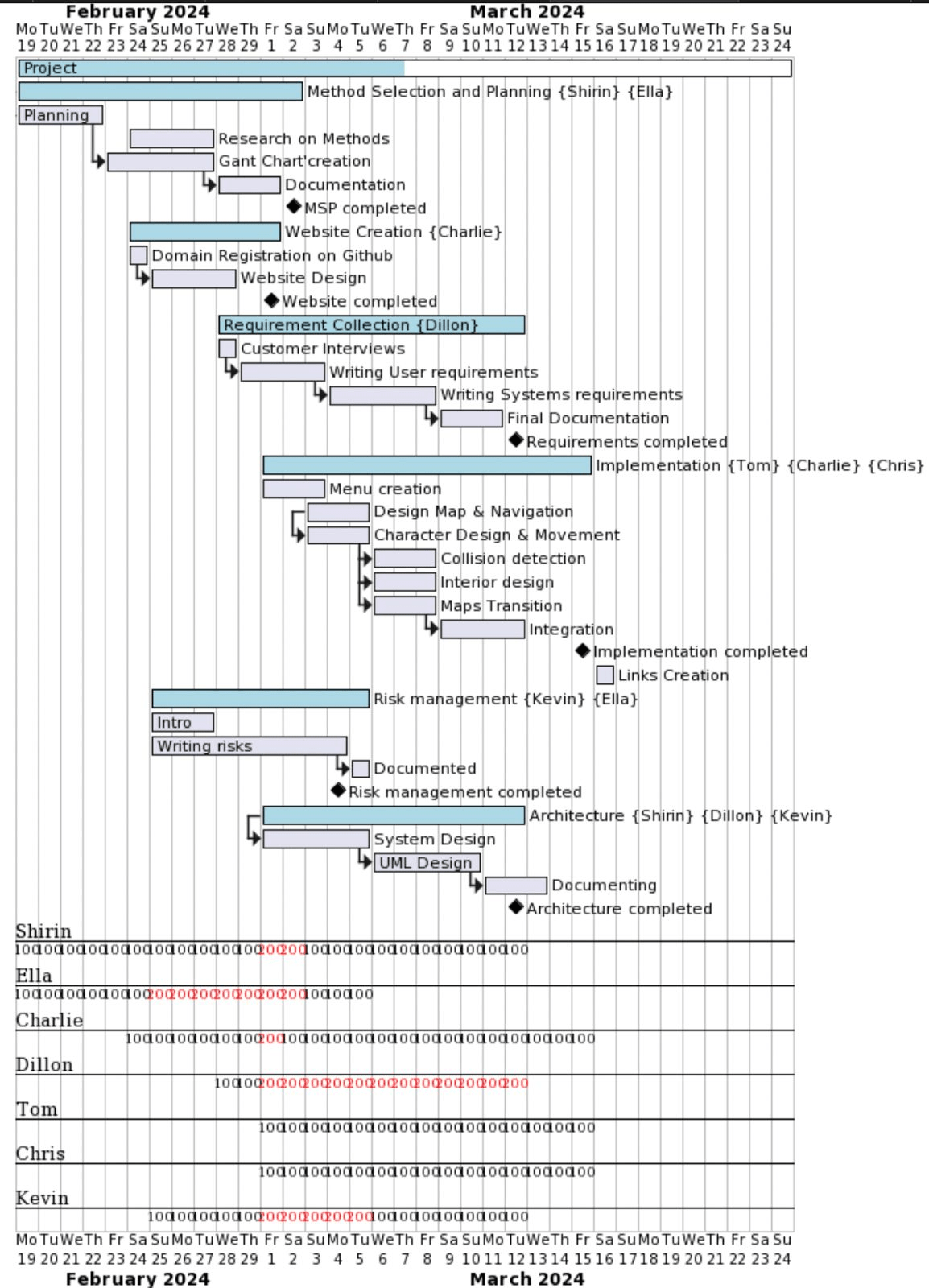

Figure 2 (Week 2)

Gannt chart 2

Key tasks:

Requirement Collection (High Priority)

Start: 2024-03-06, End: 2024-03-19

Includes Customer Interviews, Writing User/System Requirements, Documentation

Dependencies: None

Implementation (Highest Priority)

Start: 2024-02-28, End: 2024-04-11

Includes Menu Creation, Map/Navigation Design, Character Design/Movement, Collision Detection, Interior Design, Map Transitions, Integration

Dependencies: Requirement Collection

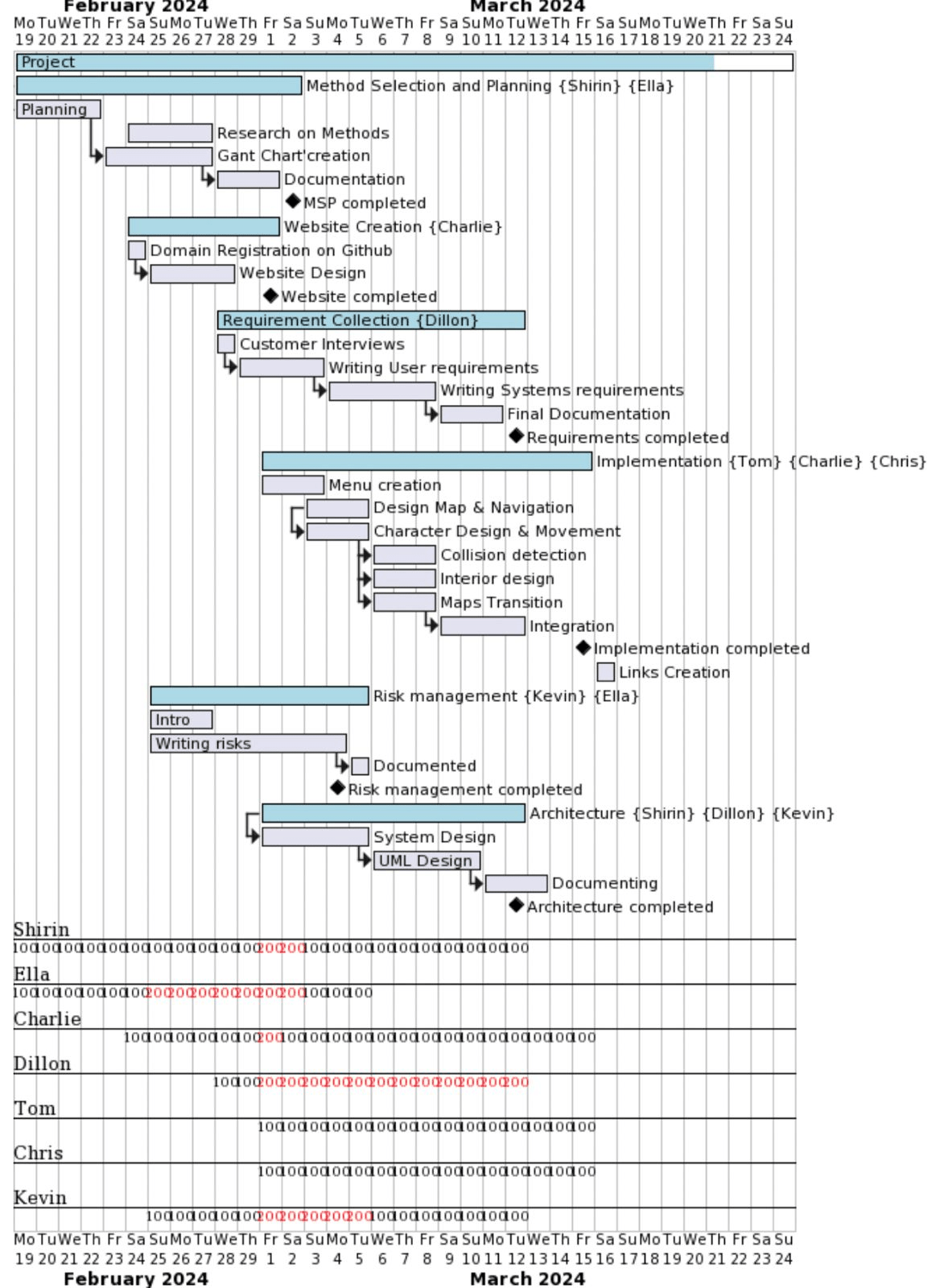

Figure 3 (Week 3)

Gannt Chart 3

Key tasks:

Architecture (High Priority)

Start: 2024-03-10, End: 2024-03-21

Includes System Design, Database Design

Dependencies: None

Links Creation (Low Priority)

Start: 2024-03-16, End: 2024-03-16

Dependencies: Implementation, Website Creation, Architecture, Risk management, Method selection and planning
